Infrastructure Projects

Throughout 2021 the Village will be managing a variety of infrastructure improvement projects. In an effort to provide information about the progress of each project, web pages have been developed to provide basic information such as start and completion dates, the project location, and a description of the project. These pages will also provide regular updates as construction commences. Below are links to each project’s page.

2022 Infrastructure Improvement Project List

Project Name
Location
Status
2022 Roadway Resurfacing Program

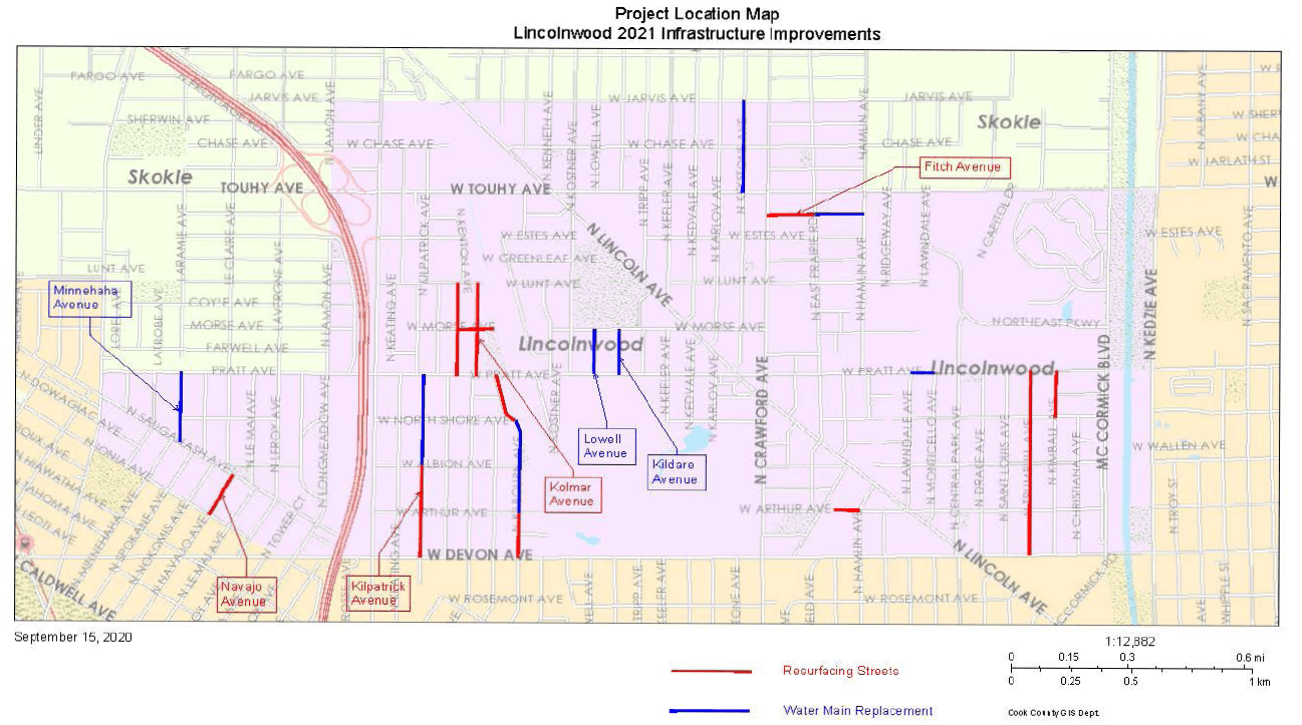

Map
Estimated Completion: Fall, 2022
Devon Avenue Improvement Project
Map
Estimated Completion: Fall 2022

Connector Road Project

Map
Estimated Completion: Fall 2022
Pratt Avenue Bicycle Lane Improvements
  Public Meeting Scheduled for June 16, 2022
at Village Hall, 6900 N. Lincoln Avenue,
Lincolnwood, Illinois 60712 at 6:00 PM

If you have any questions about these projects, please contact the Public Works Department at 847-675-0888. Please view the Infrastructure Improvement Plan (PDF).

On February 6, 2018, the Village President appointed an Ad-Hoc Infrastructure Committee (“Committee”) to review and provide a recommendation regarding a draft infrastructure improvement plan that was presented to the Village Board by Village staff at a workshop on November 30, 2017. The Committee met on four occasions to review the proposed improvement plan and funding model. On May 14, 2018, the Committee voted to approve the recommendation outlined in the report (PDF). One June 19, 2018, the Village Board reviewed and accepted the Committee’s recommendation. Over the next 10 years, the Village will be working to make various improvements including resurfacing all of the residential streets and replacing various water mains. Staff and the Village Engineer have established a draft 10-year plan that identifies when each street and water main will be improved. This plan will be evaluated and updated on an annual basis depending on the need and available funding. View the draft of the 10-year plan dated December 14, 2018 (PDF).

Infrastructure Improvement Plan Progress

The 2022 Infrastructure Program includes resurfacing of 3.58 miles of roadway. The table below provides a status of the Village’s infrastructure improvement goals at the start and end of the 2022 construction season.

Program
Goal
Progress at End of 2021 (Year 3 of 10)
Estimated End of 2022(Year 4 of 10)
Roadway Resurfacing  Resurface all 41 miles of Village roads  11.02 miles resurfaced 3.58 miles resurfaced
36% of goal
Water Main Replacement  Replace all water mains rated as “poor” and 15% of water mains rated as “fair” and installed in the 1920s 2.15 miles replaced

0 miles replaced
17.2% of goal
